Hillcrest Reconstruction Project
Much of the water, sewer, and road infrastructure in Hillcrest has reached the end of its service life and needs to be upgraded. The Hillcrest Reconstruction project is being initiated by the City of Whitehorse to renew and revitalize this public infrastructure.
- The first Hillcrest Reconstruction Project design concept was completed in 2012, then updated in 2016.
- In 2017, the Local Improvement Charge (LIC) bylaw was defeated due to a lack of community support. The 2016 conceptual designs for the improvements were prepared with input from Hillcrest residents.
- These concepts remain a valuable starting point as this process is re-initiated in 2022.
- Since 2017, the City developed the Infrastructure Reconstruction and Local Improvement Policy. The policy reflects a more commonly used approach across Canada where the City takes responsibility for replacing infrastructure within the road right of way, without the need for a neighbourhood referendum.
Property owners will be given the opportunity to take advantage of the project to upgrade their buried water and sewer service connections, most of which are now over 65 years old and are due for replacement, at their expense.
New household connections will require a recirculation system for frost protection which will dramatically reduce water consumption from bleeders. The reconstruction project encompasses replacement of all roads and buried utilities in the neighbourhood, except for Sunset Drive North between Roundel and Park Lane. This portion of the subdivision was constructed in 1979, and as such will not be upgraded at this time.
Public engagement, planning, and detailed design were completed in 2022 and 2023. The reconstruction works will be divided into four phases.
Our promise to you
We will keep Hillcrest residents involved throughout the process to ensure that your input and aspirations are consistently understood and considered.
Much of the water, sewer, and road infrastructure in Hillcrest has reached the end of its service life and needs to be upgraded. The Hillcrest Reconstruction project is being initiated by the City of Whitehorse to renew and revitalize this public infrastructure.
- The first Hillcrest Reconstruction Project design concept was completed in 2012, then updated in 2016.
- In 2017, the Local Improvement Charge (LIC) bylaw was defeated due to a lack of community support. The 2016 conceptual designs for the improvements were prepared with input from Hillcrest residents.
- These concepts remain a valuable starting point as this process is re-initiated in 2022.
- Since 2017, the City developed the Infrastructure Reconstruction and Local Improvement Policy. The policy reflects a more commonly used approach across Canada where the City takes responsibility for replacing infrastructure within the road right of way, without the need for a neighbourhood referendum.
Property owners will be given the opportunity to take advantage of the project to upgrade their buried water and sewer service connections, most of which are now over 65 years old and are due for replacement, at their expense.
New household connections will require a recirculation system for frost protection which will dramatically reduce water consumption from bleeders. The reconstruction project encompasses replacement of all roads and buried utilities in the neighbourhood, except for Sunset Drive North between Roundel and Park Lane. This portion of the subdivision was constructed in 1979, and as such will not be upgraded at this time.
Public engagement, planning, and detailed design were completed in 2022 and 2023. The reconstruction works will be divided into four phases.
Our promise to you
We will keep Hillcrest residents involved throughout the process to ensure that your input and aspirations are consistently understood and considered.
-
Hillcrest Reconstruction update
Share Hillcrest Reconstruction update on Facebook Share Hillcrest Reconstruction update on Twitter Share Hillcrest Reconstruction update on Linkedin Email Hillcrest Reconstruction update linkThe closure on Summit Road between Roundel Road and Hillcrest Drive is extended to Friday, June 19 as the City’s contractor prepares the road for resurfacing.
After June 19 Summit Road will reopen as a gravel surface with concrete curbs. Summit will be closed again later in the summer when asphalt is placed for the entire construction area.
Beginning Monday, June 15, the intersection of Roundel Road and Sunset Drive North will be closed until June 19. During this time Transit stops on Sunset Drive North will be temporarily closed and buses will detour up Hillcrest Drive, around Park Lane, and back down Hillcrest Drive. Use the Transloc app to see where your bus is in real-time.
Roundel Road continues to be closed between Summit Road and Sunset Drive North for deep utility construction. Residents of that area will be required to use alternative access until August unless they are otherwise notified.The City will continue to work with residents and the contractor, Castle Rock Enterprises, to provide temporary access when needed for fuel or other deliveries.
The City thanks the public for their patience as we work on this important infrastructure project.
The closure on Summit Road between Roundel Road and Hillcrest Drive is extended to Friday, June 19 as the City’s contractor prepares the road for resurfacing.
After June 19 Summit Road will reopen as a gravel surface with concrete curbs. Summit will be closed again later in the summer when asphalt is placed for the entire construction area.
Beginning Monday, June 15, the intersection of Roundel Road and Sunset Drive North will be closed until June 19. During this time Transit stops on Sunset Drive North will be temporarily closed and buses will detour up Hillcrest Drive, around Park Lane, and back down Hillcrest Drive. Use the Transloc app to see where your bus is in real-time.
Roundel Road continues to be closed between Summit Road and Sunset Drive North for deep utility construction. Residents of that area will be required to use alternative access until August unless they are otherwise notified.The City will continue to work with residents and the contractor, Castle Rock Enterprises, to provide temporary access when needed for fuel or other deliveries.
The City thanks the public for their patience as we work on this important infrastructure project.
-
Hillcrest road closures
Share Hillcrest road closures on Facebook Share Hillcrest road closures on Twitter Share Hillcrest road closures on Linkedin Email Hillcrest road closures linkThe road closure on Summit Road between Roundel Road and Hillcrest Drive is extended to Friday, June 12 as the City’s contractor prepares the road for resurfacing.
Due to the nature of the soils encountered during excavation, more earthwork is required, and the closure needs to be extended.
Beginning Monday, June 8, Roundel Road will be closed between Summit Road and Sunset Drive North for deep utility construction and rough grading.
Residents will be required to use alternative access until August unless they are otherwise notified.
The City will continue to work with residents and the contractor, Castle Rock EnterprisesContinue reading
The road closure on Summit Road between Roundel Road and Hillcrest Drive is extended to Friday, June 12 as the City’s contractor prepares the road for resurfacing.
Due to the nature of the soils encountered during excavation, more earthwork is required, and the closure needs to be extended.
Beginning Monday, June 8, Roundel Road will be closed between Summit Road and Sunset Drive North for deep utility construction and rough grading.
Residents will be required to use alternative access until August unless they are otherwise notified.
The City will continue to work with residents and the contractor, Castle Rock Enterprises, to provide temporary access when needed for fuel or other deliveries.
Transit routes are not affected by this work, but school bus routes may vary.
The City thanks the public for their patience as we work on this important infrastructure project.

-
Hillcrest reconstruction update
Share Hillcrest reconstruction update on Facebook Share Hillcrest reconstruction update on Twitter Share Hillcrest reconstruction update on Linkedin Email Hillcrest reconstruction update linkThis update has been edited to reflect a change in work schedule to June 12 due to ground conditions.
Reconstruction work in Hillcrest is continuing.
Between Friday, May 29 and Friday, June 12, the City’s contractor, Castle Rock Enterprises, is preparing Summit Road for resurfacing from Hillcrest Drive to Roundel Road.
Access to driveways and parking stalls on this segment of Summit Road will not be available while this work is underway.
Four mature trees require removal in order for the work to be completed safely. While the City had been planning to keep these trees in place, it was determined they would need to be removed for safety purposes.
There are no changes to Whitehorse Transit bus routes as a result of this work, but school bus routes may vary.
This work is part of the reconstruction project that began in 2025.
The City thanks the public for their patience as we work on this important infrastructure project.

This update has been edited to reflect a change in work schedule to June 12 due to ground conditions.
Reconstruction work in Hillcrest is continuing.
Between Friday, May 29 and Friday, June 12, the City’s contractor, Castle Rock Enterprises, is preparing Summit Road for resurfacing from Hillcrest Drive to Roundel Road.
Access to driveways and parking stalls on this segment of Summit Road will not be available while this work is underway.
Four mature trees require removal in order for the work to be completed safely. While the City had been planning to keep these trees in place, it was determined they would need to be removed for safety purposes.
There are no changes to Whitehorse Transit bus routes as a result of this work, but school bus routes may vary.
This work is part of the reconstruction project that began in 2025.
The City thanks the public for their patience as we work on this important infrastructure project.

-
Hillcrest reconstruction resumes
Share Hillcrest reconstruction resumes on Facebook Share Hillcrest reconstruction resumes on Twitter Share Hillcrest reconstruction resumes on Linkedin Email Hillcrest reconstruction resumes linkReconstruction work in Hillcrest has resumed.
The City’s contractor, Castle Rock Enterprises, is installing a storm main at Summit Road and Roundel Road from May 11 – 16.
The intersection will be limited to local traffic only with Transit and school buses detoured to Hillcrest Drive.
Bus stops on Sunset Drive North will be closed. Transit users should use other stops nearby, including on Hillcrest Drive. Delays can be expected. Use the Transloc app to see where your bus is in real-time.
Emergency vehicles will be provided access through the area if needed.
Local road users are asked to follow signage and direction and limit speeds to 30 kilometres per hour.
This work is part of the reconstruction project that began in 2025.
In addition to installing a storm main, the 2026 construction season will see:
- water/sewer mains and services installed
- surface work, including asphalt, gutters, and curbs
- general restoration work.
Learn more about the project at engagewhitehorse.ca
The City thanks the public for their patience as we work on this important infrastructure project.

Reconstruction work in Hillcrest has resumed.
The City’s contractor, Castle Rock Enterprises, is installing a storm main at Summit Road and Roundel Road from May 11 – 16.
The intersection will be limited to local traffic only with Transit and school buses detoured to Hillcrest Drive.
Bus stops on Sunset Drive North will be closed. Transit users should use other stops nearby, including on Hillcrest Drive. Delays can be expected. Use the Transloc app to see where your bus is in real-time.
Emergency vehicles will be provided access through the area if needed.
Local road users are asked to follow signage and direction and limit speeds to 30 kilometres per hour.
This work is part of the reconstruction project that began in 2025.
In addition to installing a storm main, the 2026 construction season will see:
- water/sewer mains and services installed
- surface work, including asphalt, gutters, and curbs
- general restoration work.
Learn more about the project at engagewhitehorse.ca
The City thanks the public for their patience as we work on this important infrastructure project.

-
April 30: Construction Season Open House
Share April 30: Construction Season Open House on Facebook Share April 30: Construction Season Open House on Twitter Share April 30: Construction Season Open House on Linkedin Email April 30: Construction Season Open House linkHi folks,
Ahead of this year's construction season the City is hosting an Open House at Decora (7 Roundel Road) on April 30 from 5 to 7 pm.
Some key topics:
Another round of introductions, including Castlerock's new Superintendent / Public Liaison - Christa (I understand she met several of you last week going door to door)
Discussion of work remaining for 2026
Presentation of Castlerock's Traffic Management Plan so people know what to expect for access, parking, alternate bus routes, etc.
Reminder about process for organics and waste collection during construction
What to expect for temporary water connections
Schedule update and key milestones
Traffic calming initiative on Hillcrest Drive this summer
General Questions and Answers
Intention is for the open house to be focused on residents around Phase 1A; however, if folks from other phases show up I can speak to the general reconstruction program.
I'll bring some snacks and Decora is open for light refreshments. We'll plan to have a few items printed off and displayed on tables.
Between myself, Associated Engineering, and Castlerock we'll be able to speak to folks as they rotate through – that being said, no pressure to show up at a specific time during that window.
Looking forward to it!
Gareth Earl, P.Eng.
Associate Manager
Engineering Services
City of WhitehorseHi folks,
Ahead of this year's construction season the City is hosting an Open House at Decora (7 Roundel Road) on April 30 from 5 to 7 pm.
Some key topics:
Another round of introductions, including Castlerock's new Superintendent / Public Liaison - Christa (I understand she met several of you last week going door to door)
Discussion of work remaining for 2026
Presentation of Castlerock's Traffic Management Plan so people know what to expect for access, parking, alternate bus routes, etc.
Reminder about process for organics and waste collection during construction
What to expect for temporary water connections
Schedule update and key milestones
Traffic calming initiative on Hillcrest Drive this summer
General Questions and Answers
Intention is for the open house to be focused on residents around Phase 1A; however, if folks from other phases show up I can speak to the general reconstruction program.
I'll bring some snacks and Decora is open for light refreshments. We'll plan to have a few items printed off and displayed on tables.
Between myself, Associated Engineering, and Castlerock we'll be able to speak to folks as they rotate through – that being said, no pressure to show up at a specific time during that window.
Looking forward to it!
Gareth Earl, P.Eng.
Associate Manager
Engineering Services
City of Whitehorse -
Update 9: Hillcrest reconstruction work update
Share Update 9: Hillcrest reconstruction work update on Facebook Share Update 9: Hillcrest reconstruction work update on Twitter Share Update 9: Hillcrest reconstruction work update on Linkedin Email Update 9: Hillcrest reconstruction work update link
Hillcrest reconstruction work will continue in 2026 following completion of about half of Phase 1A in 2025.
When complete, Phase 1A will see utility and surface work done on Roundel Road from Summit Road to Sunset Drive North and surface work on Summit Road from Roundel Road to Hillcrest Drive.
The City thanks residents for their patience and understanding, recognizing these necessary improvements have impacted traffic and resulted in noise and inconvenience in the neighbourhood.
Looking ahead to the 2026 season, the City’s contractor Castle Rock Enterprises will begin mobilizing equipment mid-May to early June for the remaining Phase 1A work:
- installation of water and sewer mains and services
- storm mains on Roundel Road from Sunset Drive to Summit Road
- surface work, including asphalt, gutters and curbs
- general restoration work.
For questions or concerns about the upcoming season, please contact project manager Gareth Earl at gareth.earl@whitehorse.ca.
Detailed design and public engagement for Phase 1B will also be underway this year. It is expected to include work on the east end of Sunset Drive North, Roundel Road east of Summit Road, and Burns Road between Roundel Road and Hillcrest Drive.
A public open house will be held in the fall.
Construction work for Phase 1B will not begin until the 2027 construction season at the earliest.
Hillcrest reconstruction work will continue in 2026 following completion of about half of Phase 1A in 2025.
When complete, Phase 1A will see utility and surface work done on Roundel Road from Summit Road to Sunset Drive North and surface work on Summit Road from Roundel Road to Hillcrest Drive.
The City thanks residents for their patience and understanding, recognizing these necessary improvements have impacted traffic and resulted in noise and inconvenience in the neighbourhood.
Looking ahead to the 2026 season, the City’s contractor Castle Rock Enterprises will begin mobilizing equipment mid-May to early June for the remaining Phase 1A work:
- installation of water and sewer mains and services
- storm mains on Roundel Road from Sunset Drive to Summit Road
- surface work, including asphalt, gutters and curbs
- general restoration work.
For questions or concerns about the upcoming season, please contact project manager Gareth Earl at gareth.earl@whitehorse.ca.
Detailed design and public engagement for Phase 1B will also be underway this year. It is expected to include work on the east end of Sunset Drive North, Roundel Road east of Summit Road, and Burns Road between Roundel Road and Hillcrest Drive.
A public open house will be held in the fall.
Construction work for Phase 1B will not begin until the 2027 construction season at the earliest.
-
Update 8: Hillcrest Reconstruction Phase 1A
Share Update 8: Hillcrest Reconstruction Phase 1A on Facebook Share Update 8: Hillcrest Reconstruction Phase 1A on Twitter Share Update 8: Hillcrest Reconstruction Phase 1A on Linkedin Email Update 8: Hillcrest Reconstruction Phase 1A link
The City is planning to temporarily shut-off water service for residents on Roundel Road from Summit Road to Sunset Drive North, Chalet Crescent and 156 Hillcrest Drive between 9 am and 5 pm on Friday, August 8, 2025.
This shut-off is part of the ongoing work for Phase 1A of Hillcrest Reconstruction.
During this time, the Whitehorse Fire Department will be prepared to respond while hydrants are out of service.
Bottled drinking water will be made available at the corner of Summit Road and Roundel Road for those who need it during the temporary shutdown. See the map below for the exact location of the station.
Residents may notice turbidity in their tap water after the work occurs. If residents find tap water is dark or cloudy, run the tap on cold for up to 15 minutes or until water appears clear.
Please contact Gareth Earl, Engineering Services Associate Manager, at (867) 689-1548 or gareth.earl@whitehorse.ca if you have any questions or concerns about this project.
The City is planning to temporarily shut-off water service for residents on Roundel Road from Summit Road to Sunset Drive North, Chalet Crescent and 156 Hillcrest Drive between 9 am and 5 pm on Friday, August 8, 2025.
This shut-off is part of the ongoing work for Phase 1A of Hillcrest Reconstruction.
During this time, the Whitehorse Fire Department will be prepared to respond while hydrants are out of service.
Bottled drinking water will be made available at the corner of Summit Road and Roundel Road for those who need it during the temporary shutdown. See the map below for the exact location of the station.
Residents may notice turbidity in their tap water after the work occurs. If residents find tap water is dark or cloudy, run the tap on cold for up to 15 minutes or until water appears clear.
Please contact Gareth Earl, Engineering Services Associate Manager, at (867) 689-1548 or gareth.earl@whitehorse.ca if you have any questions or concerns about this project.
-
Update 7: Hillcrest Reconstruction Phase 1A
Share Update 7: Hillcrest Reconstruction Phase 1A on Facebook Share Update 7: Hillcrest Reconstruction Phase 1A on Twitter Share Update 7: Hillcrest Reconstruction Phase 1A on Linkedin Email Update 7: Hillcrest Reconstruction Phase 1A linkThe City is planning to temporarily shut-off water service for residents on Roundel Road and Chalet Crescent for a period of approximately 4 hours between 8:30 am and 4:30 pm on Tuesday August 5, 2025.
This shut-off will enable the ongoing work for Phase 1A of Hillcrest Reconstruction.
During this time, the Whitehorse Fire Department will be prepared to respond while hydrants are out of service.
Bottled drinking water will be made available at the corner of Summit Road and Roundel Road for those who need it during the temporary shutdown. See the map below for the exact location of the station.
Residents may notice turbidity in their tap water after the work occurs. If residents find tap water is dark or cloudy, run the tap on cold for up to 15 minutes or until water appears clear.
Please contact Rob Dickson, Engineering Services Manager, if you have any questions or concerns about this project at (867) 687-1651 or robert.dickson@whitehorse.ca.

The City is planning to temporarily shut-off water service for residents on Roundel Road and Chalet Crescent for a period of approximately 4 hours between 8:30 am and 4:30 pm on Tuesday August 5, 2025.
This shut-off will enable the ongoing work for Phase 1A of Hillcrest Reconstruction.
During this time, the Whitehorse Fire Department will be prepared to respond while hydrants are out of service.
Bottled drinking water will be made available at the corner of Summit Road and Roundel Road for those who need it during the temporary shutdown. See the map below for the exact location of the station.
Residents may notice turbidity in their tap water after the work occurs. If residents find tap water is dark or cloudy, run the tap on cold for up to 15 minutes or until water appears clear.
Please contact Rob Dickson, Engineering Services Manager, if you have any questions or concerns about this project at (867) 687-1651 or robert.dickson@whitehorse.ca.

-
Update 6: Reconstruction Phase 1A
Share Update 6: Reconstruction Phase 1A on Facebook Share Update 6: Reconstruction Phase 1A on Twitter Share Update 6: Reconstruction Phase 1A on Linkedin Email Update 6: Reconstruction Phase 1A linkThe Hillcrest Reconstruction Project Phase 1A is well underway. Here’s what to expect in the coming weeks:
July 17 to 24
Intersection of Roundel Road and Summit Road will be closed for construction, except for emergency vehicles. Residents are asked to please follow detour signage.July 24 onwards
Construction will progress onto Roundel Road, between Summit Road and Sunset Drive North. During this time, temporary parking will be established in the greenbelt by the hockey rink and on lot 130. Access to the hockey rink has been temporarily upgraded with a granular crush surface – see route below. Please obey signage and only use this access if you are a resident of the active construction area.
The overall schedule of the Hillcrest Reconstruction project is anticipated to take roughly 10 years. There are five phases of work currently planned, with 2 years for each phase. Phases are planned as follows:
- Phase 1A (2025-2026): Roundel Road (between Summit and Sunset Drive North), Summit greenbelt sanitary main replacement, Summit resurfacing (Roundel to Hillcrest Drive)
- Phase 1B (2027-2028): Sunset Drive North (east end), Roundel Road (east of Summit), Burns Road (Roundel to Hillcrest Drive)
- Phase 2 (2029-2030): Hillcrest Drive (hwy to Kluane Crescent east), Chalet Crescent
- Phase 3 (2031-2032): Hillcrest Drive (Kluane Crescent east to west end), Kluane Crescent, Sunset Drive South
- Phase 4 (2033-2034): Park Lane and Dalton Trail
The Hillcrest Reconstruction Project Phase 1A is well underway. Here’s what to expect in the coming weeks:
July 17 to 24
Intersection of Roundel Road and Summit Road will be closed for construction, except for emergency vehicles. Residents are asked to please follow detour signage.July 24 onwards
Construction will progress onto Roundel Road, between Summit Road and Sunset Drive North. During this time, temporary parking will be established in the greenbelt by the hockey rink and on lot 130. Access to the hockey rink has been temporarily upgraded with a granular crush surface – see route below. Please obey signage and only use this access if you are a resident of the active construction area.
The overall schedule of the Hillcrest Reconstruction project is anticipated to take roughly 10 years. There are five phases of work currently planned, with 2 years for each phase. Phases are planned as follows:
- Phase 1A (2025-2026): Roundel Road (between Summit and Sunset Drive North), Summit greenbelt sanitary main replacement, Summit resurfacing (Roundel to Hillcrest Drive)
- Phase 1B (2027-2028): Sunset Drive North (east end), Roundel Road (east of Summit), Burns Road (Roundel to Hillcrest Drive)
- Phase 2 (2029-2030): Hillcrest Drive (hwy to Kluane Crescent east), Chalet Crescent
- Phase 3 (2031-2032): Hillcrest Drive (Kluane Crescent east to west end), Kluane Crescent, Sunset Drive South
- Phase 4 (2033-2034): Park Lane and Dalton Trail
-
Update 5: Reconstruction Phase 1A
Share Update 5: Reconstruction Phase 1A on Facebook Share Update 5: Reconstruction Phase 1A on Twitter Share Update 5: Reconstruction Phase 1A on Linkedin Email Update 5: Reconstruction Phase 1A linkThanks for attending Fridays in the Park on May 30! Engineering staff had a table set up and we had lots of good discussion with residents regarding Hillcrest reconstruction.

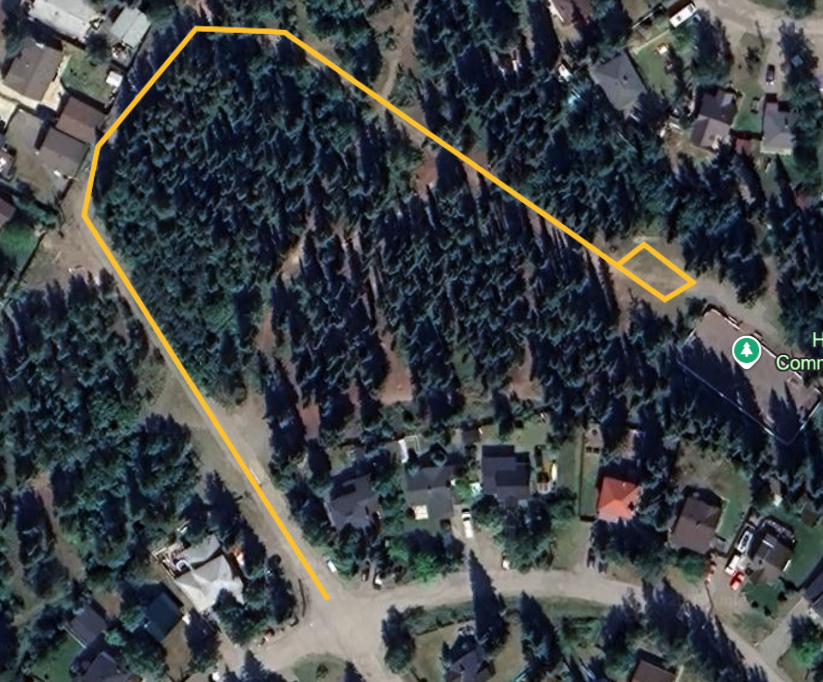

There were a few questions about the extents of tree clearing in Phase 1A and if there would be any sidewalks. Attached is a drawing showing the limits of tree clearing, which is now complete.
The project originally included tree clearing along Summit Road, south of Roundel, but that has since been removed. We are revising the design to re-align the road to preserve those trees in that area.
Also attached is a signage and line painting plan for Phase 1A. As indicated, there is no sidewalk being installed in this phase, due to narrow right-of-ways. We are currently working on a revision to this drawing that will see barrier curb installed along the southwest side of Summit, to help retain the slope. The re-alignment to preserve trees is not currently shown.
For information regarding sidewalks and general conceptual design for future phases, please download a copy of the What We Heard 2: The Roadmap report on this page.
Thanks for your interest in the project and stay tuned for more updates as we progress through construction.


Thanks for attending Fridays in the Park on May 30! Engineering staff had a table set up and we had lots of good discussion with residents regarding Hillcrest reconstruction.
There were a few questions about the extents of tree clearing in Phase 1A and if there would be any sidewalks. Attached is a drawing showing the limits of tree clearing, which is now complete.
The project originally included tree clearing along Summit Road, south of Roundel, but that has since been removed. We are revising the design to re-align the road to preserve those trees in that area.
Also attached is a signage and line painting plan for Phase 1A. As indicated, there is no sidewalk being installed in this phase, due to narrow right-of-ways. We are currently working on a revision to this drawing that will see barrier curb installed along the southwest side of Summit, to help retain the slope. The re-alignment to preserve trees is not currently shown.
For information regarding sidewalks and general conceptual design for future phases, please download a copy of the What We Heard 2: The Roadmap report on this page.
Thanks for your interest in the project and stay tuned for more updates as we progress through construction.


Follow Project
Level of Engagement
Share Information
Receive Feedback
Listen and Learn
Learn more about the City's Engagement Process
Key Dates
-
April 30 2026
-
May 15 2025 → September 30 2026
-
January 01 → December 31 2026
Timeline
-
Open
Hillcrest Reconstruction Project has finished this stageThis engagement is open for contributions and the project concept and What We Heard document are in progress.
-
Review
Hillcrest Reconstruction Project has finished this stageThe engagement period is over and the project team is reviewing the input and preparing the final conceptual design.
-
What We Heard Report
Hillcrest Reconstruction Project has finished this stageThe final outcomes of the engagement are presented to the public. This will include the What We Heard report, as well as the recommended Design Concept that will be brought to the detailed design and construction phase.
-
Property Owners Confirm Service Connection Plans
Hillcrest Reconstruction Project has finished this stageDetails regarding renewal of property owners servicing connections, financing, and confirmation (opt in) are ironed out in this stage between the City and property owners.
-
Construction
Hillcrest Reconstruction Project is currently at this stageFive phases of construction are planned, starting in 2025. The City and its contractors will ensure that there is clear communication and responsiveness to resident's concerns during this time.
Important Links
Documents
-
Hillcrest Reconstruction What We Heard 2 June 26, 2023 (10.4 MB) (pdf)
-
Hillcrest Reconstruction Update Letter, January 6, 2023 (3.41 MB) (pdf)
-
Hillcrest Reconstruction What We Heard December 5, 2022 (1.47 MB) (pdf)
-
Previous Work: Hillcrest Reconstruction 2016 Concept Summary (10.1 MB) (pdf)
-
Previous Work: 2016 Reconstruction Pre-Design Report (548 KB) (pdf)
-
Previous Work: 2016 Road and Trail Concept (242 KB) (pdf)
-
Hillcrest Reconstruction Updated Concept Maps For Public Input December 12 2022.pdf (15.4 MB) (pdf)
-
All Updated Design Cross Sections for Public Input Dec 13 2022 (206 KB) (pdf)
-
Hillcrest Reconstruction Survey 2 Questions for Reference December 15 2022 (4.07 MB) (pdf)
Who's Listening
-
Associate Manager, Engineering Services
GE
